Deliverables

List of deliverables



Time-ordered deliverables
Number Title WP Beneficiary Type Dissemination
level
Due at month date
D1.1 identification of a research partner for engineering +me 1 CNR Report Public 2 31 Oct 2020
D3.1 website development , stage one 3 CNR Website, patents Public 2 31 Oct 2020
D5.1 POPD Requirement No. 6 5 CNR Ethics Confidential 6 28 Feb 2021
D1.2 engineering process of +me 1 CNR Report Confidential 9 31 May 2021
D2.1 experimental phase, stage one 2 CNR Report Public 9 31 May 2021
D3.3 dissemination of research activities, stage one 3 CNR Report Public 10 30 Jun 2021
D1.3 me product demonstrator 1 CNR Demonstrator Public 15 30 Nov 2021
D3.2 website development , stage one 3 CNR Website, patents Public 16 31 Dec 2021
D3.4 dissemination of research activities, stage two 3 CNR Report Public 19 31 Mar 2022
D3.5 participation to market oriented events 3 CNR Report Public 20 30 Apr 2022
D1.4 final report on +me device 1 CNR Report Public 21 31 May 2022
D2.2 experimental phase, stage two 2 CNR Report Public 21 31 May 2022
D2.3 diffusion of +me to other users 2 CNR Report Public 21 31 May 2022
D4.1 final public report of project 4 CNR Report Public 21 31 May 2022



Work packages legend
WP no. WP title
1 Engineering
2 Test
3 Dissemination
4 Management
5 Ethics

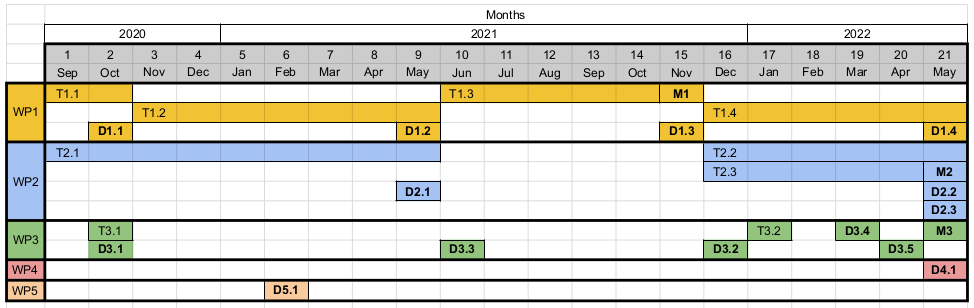

Gantt chart

Gantt showing the project schedule. Acronyms: Work Packages (WP), Tasks (T), Deliverables (D), Milestones (M).
